Medusa 2 Hydrogen powered dredging becomes reality

In a groundbreaking demonstration, Nedstack partnered with Boskalis to bring clean maritime power into practice

View site

Client

Boskalis

Date

July 2023

Services

Power generation

Three working days of dredging per hydrogen container: Boskalis, Port of Rotterdam

A dredging crane is a punishing load. It lifts, swings, drops and starts again, all day, with power demand jumping from near zero to full and back.

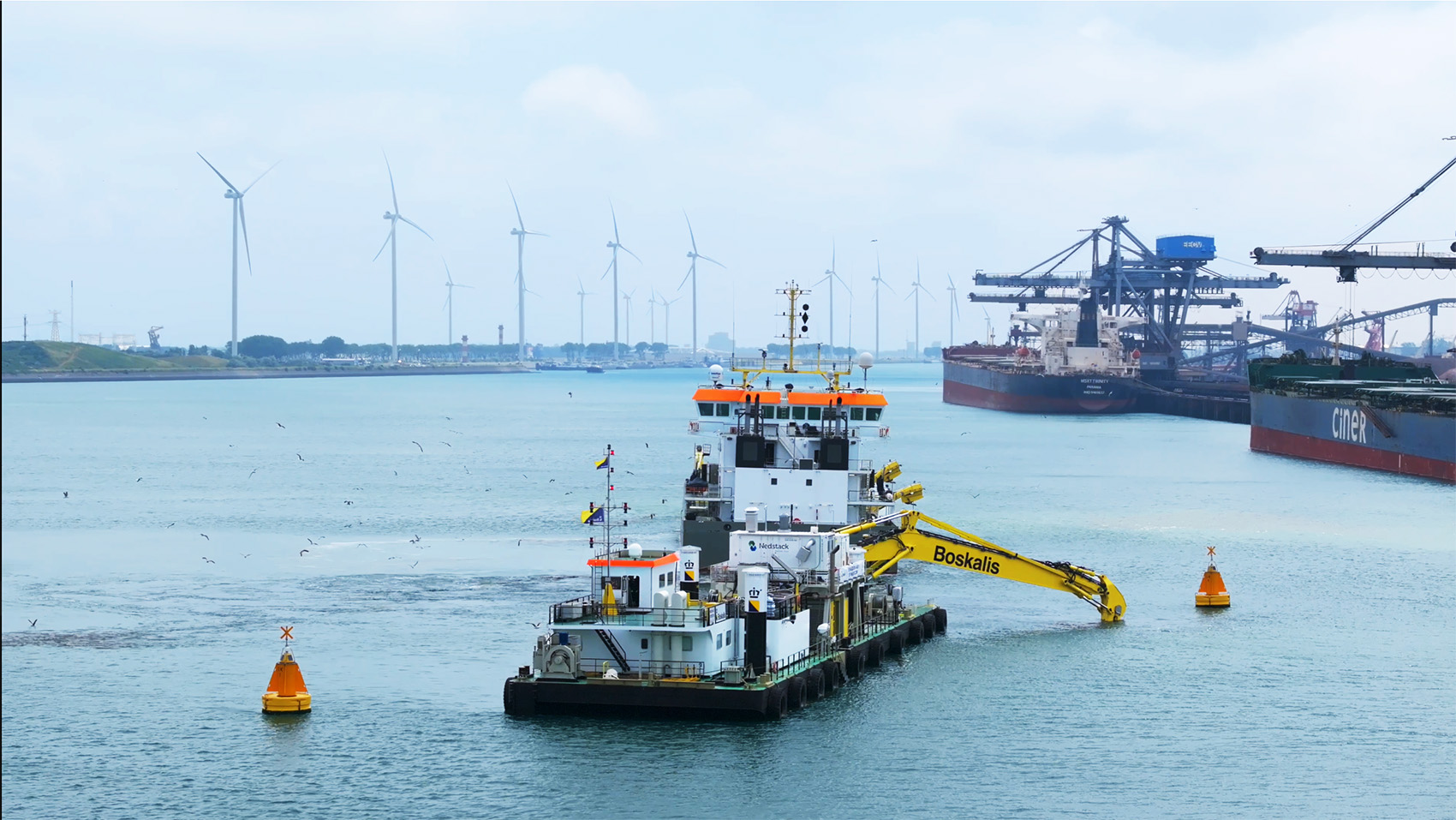

In June 2023 Boskalis put that load on hydrogen. The Medusa 2, a converted excavator pontoon, dredged at Maasvlakte 2 with its electric crane powered entirely by a Nedstack fuel cell.

It was the first time dredging in the port of Rotterdam ran on hydrogen.

The challenge

Dredging equipment runs on diesel. Boskalis wanted to know whether hydrogen could do the same job on a working site, with a real crew, not on a test bench.

The pilot had to answer three practical questions at once: does the power system cope with the crane, how does hydrogen logistics work on the water, and what does safe operation look like on board.

The system

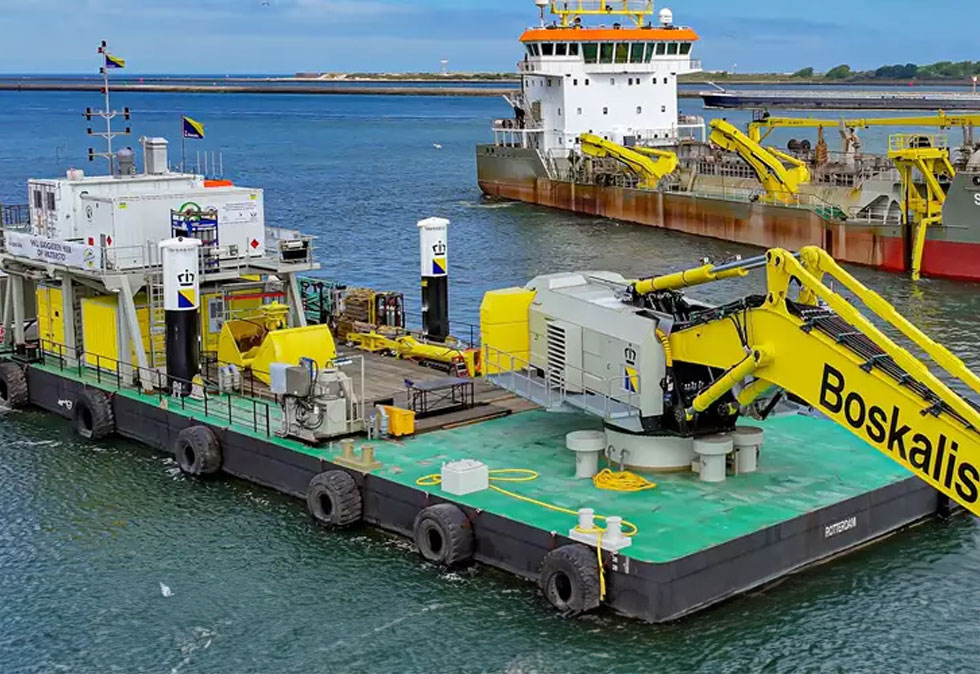

  • Vessel: Medusa 2, a converted excavator pontoon, fitted with an electric crane reaching 24 metres deep

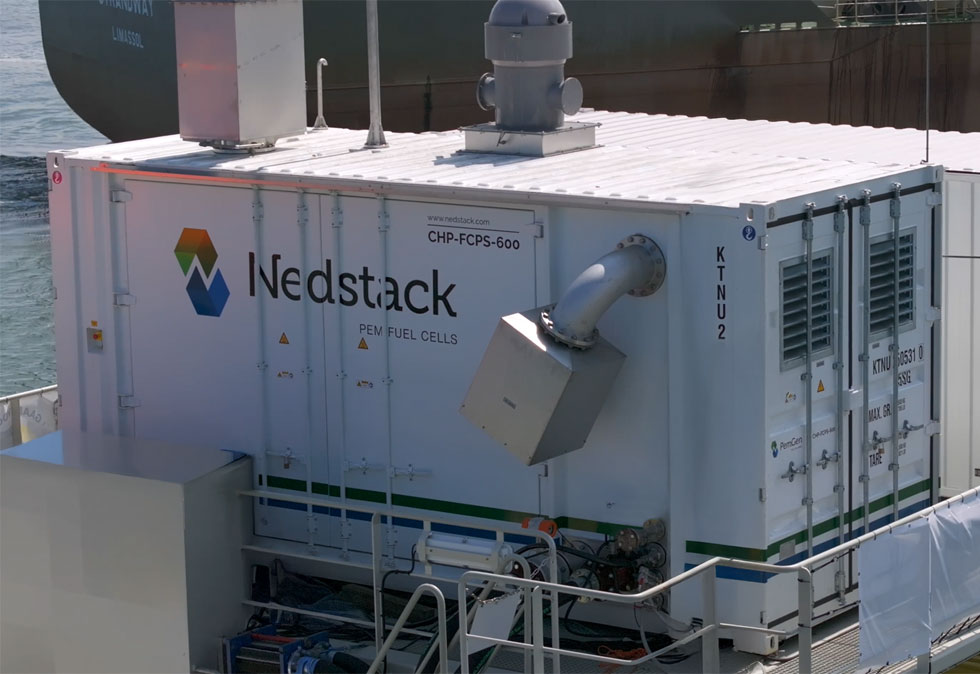

  • Fuel cell: Nedstack PemGen 600 PEM fuel cell system in a standard container
  • Hydrogen: compressed, in a second 20-ft container on board
  • Location: Maasvlakte 2, port of Rotterdam
  • Partners: Boskalis, Port of Rotterdam, ZEDhub, Nedstack, ROGER Renewable Energy
  • First hydrogen dredging: 12 June 2023

Engineering for a dredging crane

Load

The crane's demand swings hard with every cycle. The fuel cell system handled high power peaks, frequent starts and stops and continuous load variation without loss of performance.

Logistics

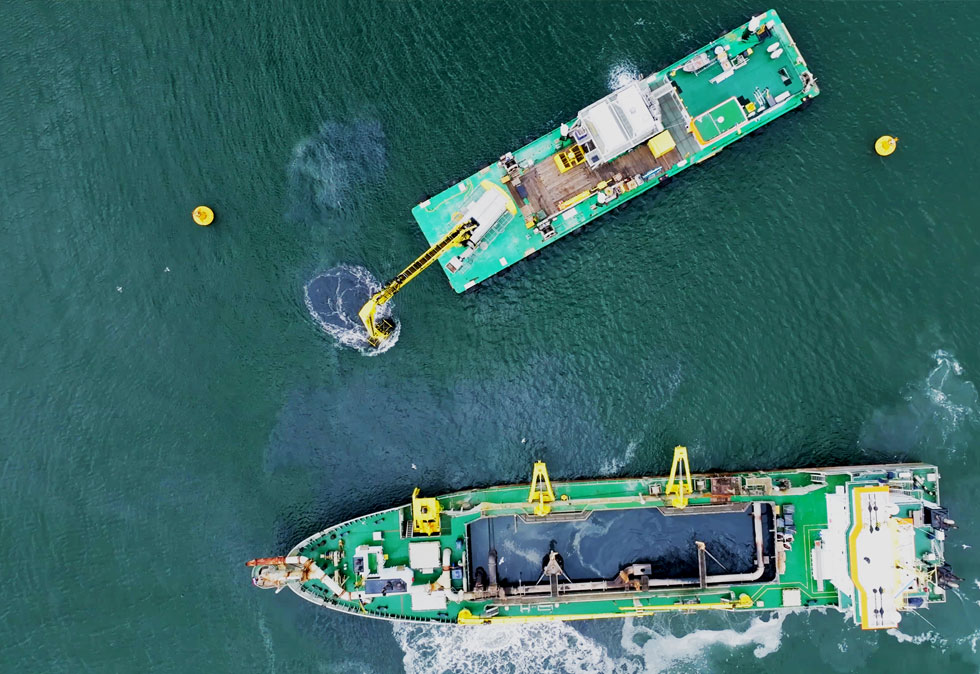

Two containers, plugged together: one with hydrogen, one with the fuel cell. Refuelling meant exchanging a container, loaded at the Maasvlakte, and one container lasted around three working days.

Safety

Hydrogen handling and safety protocols had to fit into Boskalis's existing equipment and safety setup. They worked as intended, and the crew dredged in near silence, which also counts on board.

Results

Results from the pilot at Maasvlakte 2, 2023:

MetricResult
Operation on hydrogen onlySeveral weeks of dredging
Endurance per hydrogen containerAround 3 working days
Load handlingPeaks, starts and stops without loss of performance
Emissions on siteZero

What it proved

Medusa 2 showed that a PEM fuel cell can carry one of the most irregular loads in maritime work, on a live site, with a plug-in container setup. The lesson Boskalis took away was about supply rather than the power system: hydrogen is needed in large volumes, and a safe place to load it is part of the operation.

It fitted a wider line of Nedstack's maritime work that year, alongside the Antonie and H2 Barge 1: three different vessels, three different duty cycles, the same PEM technology.

That is still the standard we design to: power that keeps going, because the work behind it can't stop.

‍
